Focus: The Revitalised Promenade

What will it look like?

View an artist’s impression of the revitalised promenade. More images to follow.

When will it happen?

Here’s a brief timeline of the key project milestones:

  • October 2024: Construction commences
  • October 2024 - February 2025:South Marine Terrace to South Road Junction
  • January 2024 - Summer 2025: South Road Junction to Pier Street
  • November 2025 - Summer 2025: Street Lighting installation from South Marine Terrace to Pier Street will be installed in stages following the main works.
  • Winter 2024/25: Street Lighting bracket and lantern replacements from Constitution Hill to Pier Street
  • Winter 2024/25: Castle Footbridges Installation

What about parking?

As the work begins, residents and visitors are encouraged to make use of Aberystwyth's Pay and Display car parks and explore season ticket options.

Future Parking Solutions

As part of the long-term plan, more parking spaces will be made available elsewhere in town. Further details will follow as development progresses.

Updates



14.11.24: Kerbing and widening works along South Marine Terrace are nearly complete, with new street lighting columns now installed and temporary LED lighting transferred from the old columns. Work has begun near The Hut on South Road junction to install new kerblines and remove the traffic island, progressing smoothly thanks to favourable weather.

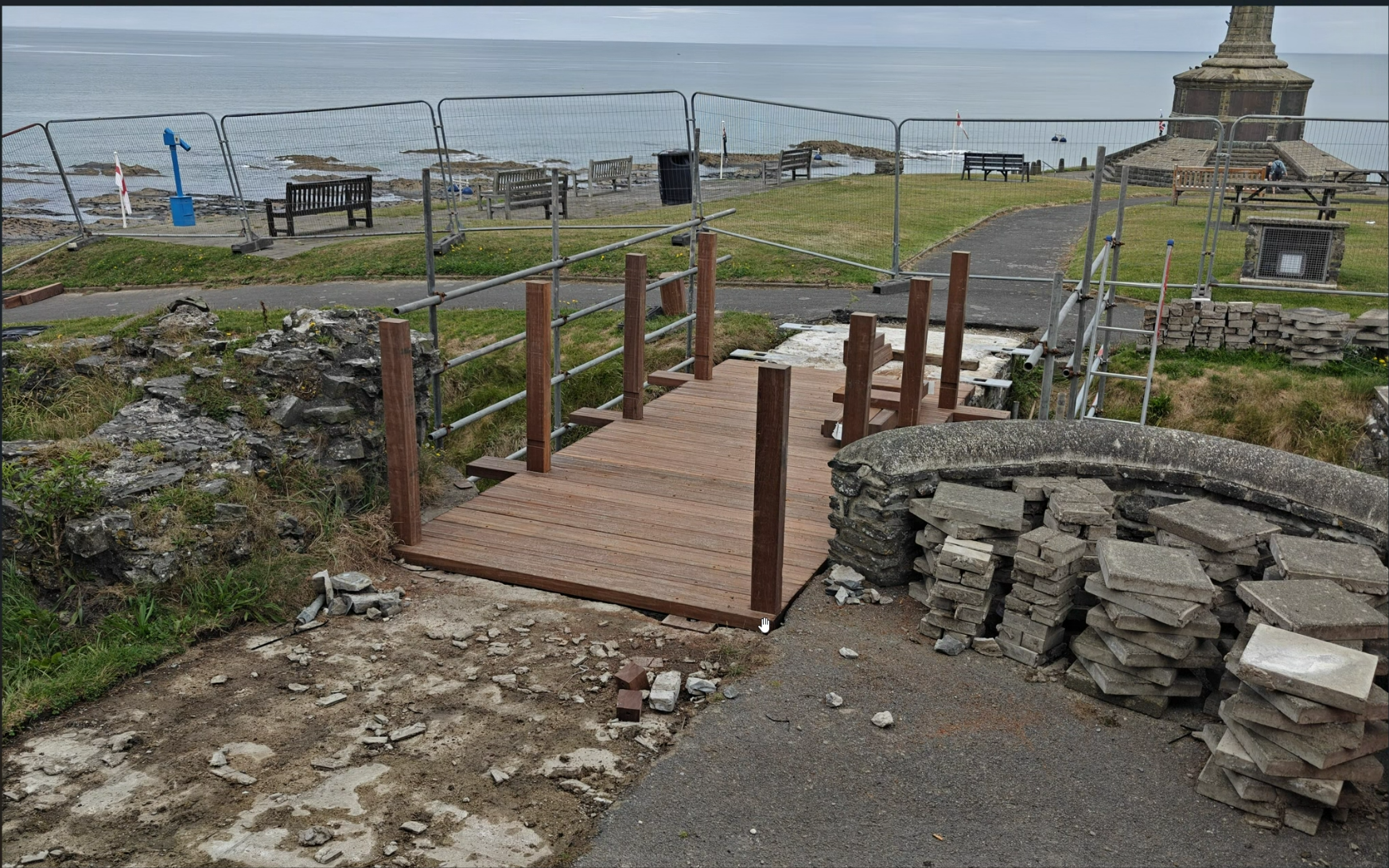

Scheduled Ancient Monument consent from CADW has been granted, allowing the replacement contract for the two Castle footbridges to be awarded. The design of the new footbridges will closely replicate the existing wooden bridges. The reconfigured South Road/South Marine Terrace junction kerblines are now in place, with slabbing, lighting, and planter foundations to follow near South Marine Terrace. Central buildouts along South Marine Terrace are also set for completion.



#
#
#
#
#
#



04.11.24: Construction is moving forward smoothly on the Aberystwyth Promenade project. The concrete access to the RNLI Ramp opposite Quay Street has been completed, while drainage works, electrical ducting, and foundations for new street lighting columns have begun. Kerbing along the new road edge is progressing well, and the footway between Quay Street and South Marine Terrace has been prepared for reinstatement, with kerbing integrated into the existing pathways.

Pavement installation between Quay Street and South Marine Terrace is nearing completion, and the increased width of the promenade is becoming evident, promising improved shared space for pedestrians and cyclists. Kerbing along South Marine Terrace continues as scheduled, and the installation of street lighting columns, along with decorative brackets from Pier Street to Castle Point, has been completed. These await the new lanterns, expected later this year. Work on drainage systems, ducting, and foundations for street lighting will also continue throughout the week.



#
#
#
#
#
#



16.10.24: Work on the Aberystwyth Promenade began on 9th October 2024. Tregaron Trading Services Ltd (TTS) has set up welfare facilities and a storage area near South Marine Terrace and Riverside Terrace. Initial construction focused on laying kerbs between Quay Street and South Marine Terrace, and the outline of the new parking spaces is now visible. Traffic management and barriers have been installed for upcoming kerbing and footway improvements. Next week, kerbing and footway work will continue, and preparations for new street lighting installation will begin.

#
#
#
#
#

Regular updates on the project will be available on this page.

If you want to be notified when this page is updated, please send your contact details to PromAber@ceredigion.gov.uk to be added to our mailing list.
